ESCL Conference August 25th 2006 - PowerPoint PPT Presentation

1 / 16
About This Presentation
Title:

ESCL Conference August 25th 2006

Description:

... Conditions of Contract for EPC Turnkey Projects (1999; EPC being the abbreviation for Engineer-Procure-Construct) (the Silver Book ); ... – PowerPoint PPT presentation

Number of Views:33
Avg rating:3.0/5.0
Slides: 17
Provided by: AlfaLava
Learn more at: http://www.escl.org
Category:

less

Transcript and Presenter's Notes

Title: ESCL Conference August 25th 2006

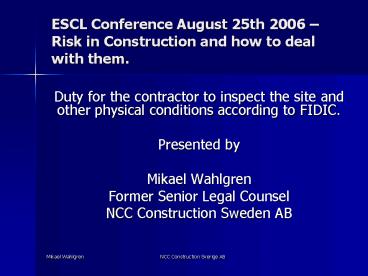

1
ESCL Conference August 25th 2006 Risk in
Construction and how to deal with them.
  • Duty for the contractor to inspect the site and
    other physical conditions according to FIDIC.
  • Presented by
  • Mikael Wahlgren
  • Former Senior Legal Counsel
  • NCC Construction Sweden AB

2
FIDICs old standard forms
  • Conditions of Contract for Works of Civil
    Engineering Construction, Fourth Edition, 1987
    (reprinted in 1988 with editorial amendments and
    reprinted in 1992 with further amendments) (the
    old Red Book)
  • Conditions of Subcontract for Works of Civil
    Engineering, Construction, First Edition, 1994
    (to function with the old Red Book)
  • Conditions of Contract for Electrical and
    Mechanical Works, Third Edition, 1987 (reprinted
    in 1988 with editorial amendments) (the old
    Yellow Book) and
  • Conditions of Contract for Design-Build and
    Turnkey, First Edition, 1995 (the Orange Book).
  • Client-Consultant Model Services Agreement (3rd
    Ed., 1998, ) ("White Book")

3
FIDICs (the International Federation of
Consulting Engineers) new standard forms
  • Conditions of Contract for Construction (1999
    for building and engineering works designed by
    the employer) (the new Red Book)
  • Conditions of Contract for Plant and Design-Build
    (1999 for electrical and mechanical plant and
    for building and engineering works designed by
    the contractor) (the new Yellow Book)
  • Conditions of Contract for EPC Turnkey Projects
    (1999 EPC being the abbreviation for
    Engineer-Procure-Construct) (the Silver Book)
    and
  • Short Form of Contract (1999 for projects of
    relatively small value) (the Green Book).

4
Clause 4.10 (new Red Book Yellow Book) Site
Data
  • The Employer shall have made available to the
    Contractor for his information, prior to the Base
    Date, all relevant data in the Employers
    possession on sub-surface and hydrological
    conditions at the Site, including environmental
    aspects. The Employer shall similarly make
    available to the Contractor all such data which
    come into the Employers possession after the
    Base Date. The Contractor shall be responsible
    for interpreting all such data.

5
Clause 4.10 (new Red Book Yellow Book) Site
Data (cont.)
  • To the extent which was practicable (taking
    account of cost and time), the Contractor shall
    be deemed to have obtained all necessary
    information as to risks, contingencies and other
    circumstances which may influence or affect the
    Tender or Works. To the same extent, the
    Contractor shall be deemed to have inspected and
    examined the Site, its surroundings, the above
    data and other available information, and to have
    been satisfied before submitting the Tender as to
    all relevant matters including (without
    limitation)
  • (a) the form and nature of the Site, including
    sub-surface conditions,
  • (b) the hydrological and climatically conditions,
  • (c) the extent and nature of the work and Goods
    necessary for the execution and completion of the
    Works and the remedying of any defects,
  • (d) the laws, procedures and labour practices of
    the Country (means the country in which the Site
    (or most of it) is located, where the Permanent
    Works are to be executed), and
  • (e) the Contractors requirement for access,
    accommodation, facilities, personnel, power,
    transport, water and other services.

6
Clause 4.10 (Silver Book) Site Data
  • The last sentence of paragraph 1 have been
    deleted and replaced the 2nd paragraph with the
    following wording
  • The Contractor shall be responsible for
    verifying and interpreting all such data. The
    Employer shall have no responsibility for the
    accuracy, sufficiency or completeness of such
    data, except as stated in Sub-Clause 5.1 General
    Design Responsibilities.

7
Comments to Clause 4.10 Site Data
  • In the new Red Book and new Yellow Book
  • Constitutes a step backwards for the Contractor
    by inserting the words relevant data in the
    Employers possession.
  • Reference to relevant data limits the
    information to be provided by the Employer.
  • Contractors are advised to amend this requirement
    so that the Employer is required to supply all
    available data on hydrological and sub-surface
    conditions.
  • In the new Yellow Book should be expanded to
    include all information relevant to the
    Contractors design.

8
Comments to Clause 4.10 Site Data (cont.)
  • In the Silver Book
  • The Contractor is responsible for verifying data
    - particularly, verifying and interpreting all
    data on subsurface and hydrological conditions,
    including environmental aspects.
  • Carefully scrutinise the precise extent to which
    the exceptions offered under Sub-Clause 5.1.
  • The disclaimer covers any information provided
    during the performance of the Works - the
    Contractor cannot rely on information provided by
    the Employer during the execution of the
    Contract.
  • FIDIC recognise that, the Silver Book is not
    suitable for use where there is insufficient
    time or information for tenderers to scrutinise
    and check the Employer's Requirements or for them
    to carry out their designs, risk assessment
    studies and estimating - FIDIC's alternative is
    the Yellow Book.

9
Clause 4.12 (new Red Book Yellow Book)
Unforeseeable Physical Conditions
  • In this Sub-Clause, physical conditions means
    natural physical conditions and man-made and
    other physical obstructions and pollutants, which
    the Contractor encounters at Site when executing
    the Works, including sub-surface and hydrological
    conditions but excluding climatic conditions.
  • If the contractor encounters adverse physical
    conditions which he considers to have been
    Unforeseeable, the Contractor shall give notice
    to the Engineer as soon as possible.
  • This notice shall describe the physical
    conditions, so they can be inspected by the
    Engineer, and shall set out the reasons why the
    Contractor considers them to be Unforeseeable
    (means not reasonably foreseeable by an
    experienced contractor by the date for submission
    of the Tender). The Contractor shall continue
    executing the Works, using such proper and
    reasonable measures as are appropriate for the
    physical conditions, and shall comply with any
    instructions which the Engineer may give. If an
    instruction constitutes a Variation (means any
    change to the Works, which is instructed or
    approved as a variation), under Clause 13
    Variations and Adjustments shall apply.

10
Clause 4.12 (new Red Book Yellow Book)
Unforeseeable Physical Conditions (cont.)
  • If and to the extent that the Contractor
    encounters physical conditions which are
    Unforeseeable, gives such a notice, and suffers
    delay and/or incurs Cost by the Contractor,
    whether on or off the Site, including overhead
    and similar charges, but does not include profit)
    due to these conditions, the Contractor shall be
    entitled subject to Sub-Clause 20.1 Contractors
    Claim to
  • an extension of time for any such delay, if
    completion is or will be delayed, under
    Sub-Clause 8.4 Extension of Time for
    Completion, and
  • (b) Payment of any such Cost, which shall be
    included in the Contract Price.
  • After receiving such notice and inspecting and/or
    investigating these physical conditions, the
    Engineer shall proceed in accordance with
    Sub-Clause 3.5 Determination to agree or
    determine (i) whether and (if so) to what extent
    these physical conditions were Unforeseeable, and
    (ii) the matter described in sub-paragraphs (a)
    and (b) above related to this extent.

11
Clause 4.12 (new Red Book Yellow Book)
Unforeseeable Physical Conditions (cont.)
  • However, before additional Cost is finally agreed
    or determined under sub-paragraph (ii), the
    Engineer may also review whether other physical
    conditions in similar parts of the Works (if any)
    were more favourable than could reasonably have
    been foreseen when the Contractor submitted the
    Tender. If and to the extent that these more
    favourable conditions were encountered, the
    Engineer may proceed in accordance with
    Sub-Clause 3.5 Determination to agree or
    determine the reductions in Cost which were due
    to these conditions, which may be included (as
    deductions) in the Contract Price and Payment
    Certificates. However, the net effect of all
    adjustments under sub-paragraph (b) and all these
    reductions, for all the physical conditions
    encountered in similar parts of the Works, shall
    not result in a net reduction in the Contract
    Price.
  • The Engineer may take account of any evidence of
    the physical conditions foreseen by the
    Contractor when submitting the Tender, which may
    be made available by the Contractor, but shall
    not be bound, by any such evidence.

12
Clause 4.12 (Silver Book) Unforeseeable
Difficulties
  • Except as otherwise stated in the Contract
  • (a) the Contractor shall be deemed to have
    obtained all necessary information as to risks,
    contingencies and other circumstances which may
    influence or affect the Works
  • (b) by signing the Contract, the Contractor
    accepts total responsibility for having foreseen
    all difficulties and costs of successfully
    completing the Works and
  • (c) the Contract Price shall not be adjusted to
    take account of any unforeseen difficulties or
    costs.

13
Clause 4.12 (new Red Book Yellow Book)
Unforeseeable Physical Conditions
  • Unforeseeable is a defined term not
    reasonably foreseeable by an experienced
    Contractor by the date of submission of the
    Tender.
  • Entitlement to recover additional costs will not
    include profit.
  • Relief for cost and time due to unforeseeable
    natural physical conditions and man made and
    other physical obstructions or pollutants and
    including subsurface and hydrological
    conditions.
  • No relief due to impediments encountered off the
    site.
  • Excludes climatic events.
  • Engineer may take into account whether other
    Physical Conditions in similar parts of the Works
    (if any) were more favourable than could
    reasonably have been foreseen when the Contractor
    submitted its Tender.
  • New concept that allows for the Contractor to
    provide evidence of the physical conditions
    foreseen in his tender calculation.
  • An alternative is to agree the foreseeable
    conditions beforehand.

14
Clause 4.12 (Silver Book) Unforeseeable
Difficulties
  • The language is uncompromising in the extreme and
    its scope and application are much more
    wide-ranging.
  • The consequential effects of all unforeseen
    difficulties are passed to the Contractor,
    Except as otherwise stated in the Contract.
  • The Contractor is to foresee and allow in the
    price for every eventuality however
    unforeseeable!
  • It is difficult to imagine a clause which would
    be more threatening to contractors - Contractors
    should beware!

15
Conclusion final notes
  • The main reason for the diminishing use of the
    FIDIC standard forms
  • need quite substantive amendments
  • many law firms have produced and promote their
    own bespoke contract forms and
  • the number of competing standard forms.

16
Conclusion final notes (cont.)
  • Regions where FIDIC standard forms are used
  • projects in Africa and Asia.
  • projects financed by the World Bank.
  • Under US law, where the contractor has a duty to
    inspect, that duty does not include taking its
    own soil borings. A contractor is entitled to
    rely on the borings provided by the Employer.
  • The new Red and Yellow Book (clause 4.12) can
    give time and money for unforeseen site
    conditions whereas Silver Book says largely the
    reverse the Contract Price should not be
    adjusted for unforeseen difficulties or cost.
  • If the Silver clauses remain unchanged,
    contractors may try (if the facts justify it) to
    claim for
  • site conditions on the basis that the Employer
    did not make relevant data available (clause
    4.10)
  • ground conditions on the basis of inability to
    verify (clause 5.1(d)) and
  • Force Majeure in extreme cases (clause 19.1).
Write a Comment
User Comments (0)
About PowerShow.com
