MIE 353 Engineering Economics Todays Goals

1 / 41
About This Presentation
Title:

MIE 353 Engineering Economics Todays Goals

Description:

7. Performance monitoring and post-evaluation results. Decision Making ... As we've seen, once you consider taxes, you often lose nice annuity properties. ... – PowerPoint PPT presentation

Number of Views:46
Avg rating:3.0/5.0
Slides: 42
Provided by: erinb45

less

Transcript and Presenter's Notes

Title: MIE 353 Engineering Economics Todays Goals


1

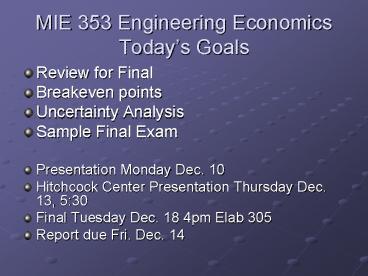

MIE 353 Engineering EconomicsTodays Goals
  • Review for Final
  • Breakeven points
  • Uncertainty Analysis
  • Sample Final Exam
  • Presentation Monday Dec. 10
  • Hitchcock Center Presentation Thursday Dec. 13,
    530
  • Final Tuesday Dec. 18 4pm Elab 305
  • Report due Fri. Dec. 14

2
Homework EVPI
0
Without information
858
CD
p.5
.5
3
stock
real estate
522
.3
292
.5
1030
.2
3
Homework EVPI
0
Without information
858
CD
p.5
430
.5
3
stock
real estate
522
.3
292
.5
509
1030
.2
4
Homework EVPI
0
Without information
858
CD
p.5
Choose Real Estate for an expected value of 509
430
.5
3
stock
real estate
3444
.3
292
.5
509
1030
.2
5
Homework EVPI
With information learn then act
CD
0
stock
858
p.5
509
.5
CD
0
stock
3
509
6
Homework EVPI
With information learn then act
If the stock goes up, choose stock. If the stock
goes down, choose real estate.
CD
0
stock
858
p.5
509
.5
CD
0
stock
3
509
7
Homework EVPI
With information learn then act
If the stock goes up, choose stock. If the stock
goes down, choose real estate. EV with
information is 683
CD
0
stock
858
p.5
509
.5
CD
0
683
stock
3
509
8
Homework EVPI
With information learn then act
If the stock goes up, choose stock. If the stock
goes down, choose real estate. EV with
information is 683
CD
0
stock
858
p.5
509
.5
CD
0
683
EVPI 683 509 174
stock
3
509
9
ENGINEERING ECONOMIC ANALYSIS PROCEDURE
  • Recognize Opportunity (Problem definition).
  • Selection of a criterion ( or criteria).
  • 3. Development of alternatives.
  • 4. Development of the prospective outcomes
    (typically cash flows).
  • 5. Analysis and comparison of the alternatives.
  • 6. Selection of the preferred alternative.
  • 7. Performance monitoring and post-evaluation
    results.

10
Decision Making Steps
  • Define Values
  • What you will use to evaluate the alternatives
  • Generate Alternatives
  • Gather information and develop cash flows
  • Evaluate and compare cash flows (and other
    non-monetized items)
  • Perform sensitivity analysis

11
Calculate PW of an arbitrary cash flow
  • Find the interest rate per cash flow.
  • Discount each cash flow to the present and add
    them up.
  • ak (P/F,i,k) ak/(1i)k
  • ak cash flow at period k
  • i interest rate per cash flow period
  • k period
  • PW

12
PW arbitrary
  • You can always just find the PW of each cash flow
    and add them.
  • As weve seen, once you consider taxes, you often
    lose nice annuity properties.
  • Example A firm has MARR 10 and the following
    annual cash flows, starting at time 0
  • (-100 5 10 12 13 13 40)
  • PW -100 5/1.1 10/1.12 12/1.1313/1.14
    13/1.15 40/1.16

13
Formulas
  • We use the formulas for P/A and A/P when we
    happen to have a nice annuity. They are short
    cuts. You can always find the PW as shown on the
    previous page.
  • We also use the formulas when we want to find an
    annuity.

14
Example
  • A firm would like to know the annual worth of the
    following cash flow over its useful life. Their
    MARR is 10.
  • (-100 10,10,50,50,50)
  • Find PW -100 10/1.1 10/1.12
    50/1.1350/1.14 50/1.15 20.12
  • AW (A/P,.1,5) 20.12.2638 5.31

15
Groupwork example
  • A person needs 18,000 immediately. They get a
    loan, and are required to repay the loan in equal
    payments every six months over the next 12 years.
    The interest is 10 nominal, compounded monthly.
    What is amount of each payment?
  • If she wants to pay it back over 10 years, what
    would her semi annual payment be?
  • If she wants to pay 6000 every six months, how
    long will it take her to pay it off?
  • If she wants to pay 1000 a month, how long will
    it take to pay off?

16
Solutions
  • Compounding monthly payment period 6-months.
    Calc interest i (1.1/12)6 -1 .051 N 24 6
    month periods
  • Semi-annual payment is A 18(A/P, i ,24)
  • Over 10 years A 18(A/P, i ,20)
  • Solve for N, plugging in i above
  • 6(P/A, i, N) 18

N 3.33 half years, about 20 months.
17
Solutions
  • Solve for N,
  • use i .1/12
  • 1(P/A, i, N) 18

N 19.6 months
18
Comparing Projects
  • Use an equivalent worth method.
  • You cannot compare projects by simply comparing
    the IRR. If you do this, you are implicitly
    assuming that any excess cash is being
    re-invested at the IRR, rather than the MARR. In
    order to use IRR, you must do an incremental
    comparison.
  • Choose project whose PW is highest.
  • equivalently, choose project whose AW or FW is
    highest.

19
Comparing Projects with different useful lives
  • If projects have different useful lives, you must
    make an assumption. Make one assumption or the
    other they are different and will give you
    different answers.
  • Assumption 1 Repeatability
  • Assumption 2 Co-termination

20
Assumptions
  • Repeatability assumes that the alternatives can
    be repeated an indefinite number of times.
  • This is a convenient assumption
  • This is often a very reasonable assumption.
  • Equipment that is used for the basic line of
    business
  • Projects that are very typical for the firm

21
Assumptions
  • Repeatability 2 equivalent methods.
  • Method 1 Find the AW over the respective useful
    lives. This is often the easiest method.
  • Method 2 Repeat each project until they end at
    the same time and calculate PW.

22
Example
  • Don is deciding between buying a new car and
    selling it after 10 years, or buying a used car
    and selling it after 7 years. The new car cost
    20,000, can be sold for 2000 after 10 years and
    is estimated to have annual running costs of
    5000. The used car will cost 7000, can be sold
    for 2500 after 7 years, and is estimated to have
    annual running costs of 7000. Dons Marr is 5.
    Which car should he buy?

23
Example
  • Assume repeatability.
  • AW1 20,000(A/P,.05,10) 5000
    2000(A/F,.05,10)
  • 20,000.1295 5000 2000.0795 7431
  • AW2 7000(A/P, .05, 7) 7000 2500(A/F,.05,7)
  • 7000.1728 7000 -2500.1228 7902
  • Choose Car A, lower AW over useful life.
  • What is the breakeven running cost for car 2?

24
Example
  • Assume repeatability.
  • AW1 20,000(A/P,.05,10) 5000
    2000(A/F,.05,10)
  • 20,000.1295 5000 2000.0795 7431
  • AW2 7000(A/P, .05, 7) 7000 2500(A/F,.05,7)
  • 7000.1728 7000 -2500.1228 7902
  • Choose Car A, lower AW over useful life.
  • What is the breakeven running cost for car 2?
  • 7000-(7902-7431) 7000-4716529

25
Assumptions
  • Co-termination the projects cannot be repeated.
    We need to make appropriate assumptions in order
    that both projects end at the same time.
  • Specialized equipment that can only be used for a
    specific project.
  • Specialized projects that are atypical.
  • A known end date, i.e. graduation from college a
    tax benefit that is ending etc.

26
Cotermination AssumptionUseful life lt Study
Period
  • Cost alternatives -- each cost alternative must
    provide same level of service as study period
  • contract for service or lease equipment for
    remaining time
  • repeat part of useful life of original
    alternative until study period ends
  • investment alternatives -- assume all cash flows
    reinvested in other opportunities at MARR to end
    of study period. This is just equivalent to
    assuming the project ends at its useful life.

27
Cotermination AssumptionUseful life gt Study
Period
  • Truncate the alternative at the end of the study
    period using an estimated market value. This
    method assumes disposable assets will be sold at
    the end of the study period at that value.

28
Sensitivity Analysis Breakeven points
  • If you are considering one project, the breakeven
    point is where the PW0.
  • If you are comparing projects, the breakeven
    point is where the PWs of the two projects are
    equal.

29
Sensitivity Analysis Breakeven points
  • If you are considering one project, the breakeven
    point is where the PW0.
  • If you are comparing projects, the breakeven
    point is where the PWs of the two projects are
    equal.
  • Simply find an expression for the PW(s), set them
    equal and solve.

30
Example
  • A firm is choosing a generator. They want to
    minimize the total cost over 10 years. They use
    about 100 KwH per year. MARR 10.
  • Find which generator is best
  • What is breakeven for KwH
  • What is breakeven for initial cost of Generator
    1?
  • What is breakeven for salvage cost of generator 1?

31
Calc PW
  • PW I c KwH (P/A,i,10) SV(P/F,i,10)
  • PW110002100(6.1446) 120(.3855)
  • 2275
  • PW220001100(6.1446) 150(.3855)
  • 2672

32
Calc PW
  • PW I c KwH (P/A,i,10) SV(P/F,i,10)
  • PW110002100(6.1446) 120(.3855)
  • 2275
  • PW220001100(6.1446) 150(.3855)
  • 2672

Choose Generator 1 lower cost.
33
Breakeven KwH
  • PW I c KwH (P/A,i,10) SV(P/F,i,10)
  • PW110002X(6.1446) 120(.3855)
  • 104612.28X
  • PW220001X(6.1446) 150(.3855)
  • 20586.14X
  • 104612X 20586X
  • 6X1012
  • X169
  • If KwH are greater than 169, which alt is better?

34
Breakeven for initial cost of Gen 1
  • PW I c KwH (P/A,i,10) SV(P/F,i,10)
  • PW1X2100(6.1446) 120(.3855)
  • 1275X
  • PW220001100(6.1446) 150(.3855)
  • 2672
  • 1275X 2672
  • X1397
  • What does this tell us?

35
Uncertainty Analysis
  • If uncertainty is important, then choose the
    alternative with the highest expected PW
  • Example say a parameter can be high with
    probability .22 or low with probability .78.
    Assume we want to maximize PW.

P.22
Value if high 27,000
1-P.78
Value if low 12,000
36
Uncertainty Analysis
  • If uncertainty is important, then choose the
    alternative with the highest expected PW
  • Example say a parameter can be high with
    probability .22 or low with probability .78

P.22
Expected value of alternative 15,300
Value if high 27,000
1-P.78
Value if low 12,000
37
Uncertainty Analysis
  • Example say a parameter can be high with
    probability .22 or low with probability .78
  • Alternative 2 has a certain payoff of 20,000
  • Choose Alternative 2, since the expected payoff
    is higher

P.22
Expected value of alternative 15,300
Value if high 27,000
1-P.78
Value if low 12,000
38
Uncertainty Analysis EVPI
  • Consider the problem if you learn then act
  • Alternative 2 has a certain payoff of 20,000
  • Choose Alternative 2, since the expected payoff
    is higher
  • The value of the decision problem is 20,000

P.22
Expected value of alternative 15,300
Value if high 27,000
1-P.78
Value if low 12,000
39
EVPI Learn then act
  • EVPI 21,540 20,000 540

Alt 1
27,000
P.22
20,000
Alt 2
Alt 1
12,000
1-P.78
20,000
Alt 2
40
EVPI
  • EVPI 21,540 20,000 540

Alt 1
27,000
27,000
P.22
20,000
21,540
Alt 2
Alt 1
12,000
1-P.78
20,000
20,000
Alt 2
41
Final
  • Decision analysis and EVPI (ch18.4-5)
  • Taxes (ch16-17)
  • Interest calculations (ch 4)
  • Cost estimations (ch15)
  • Choosing between alternatives with different
    useful lives (ch 5.3 6)
  • Breakeven analysis (ch13)
  • IRR (ch 7-8)
  • Decision Making Steps
Write a Comment
User Comments (0)
