Impact of "Cost As the Independent Variable": PM must balance elements differently - PowerPoint PPT Presentation

About This Presentation
Title:

Impact of "Cost As the Independent Variable": PM must balance elements differently

Description:

Title: Impact of – PowerPoint PPT presentation

Number of Views:19
Avg rating:3.0/5.0
Slides: 42
Provided by: dsmc2
Learn more at: http://asmcyankee.org
Category:

less

Transcript and Presenter's Notes

Title: Impact of "Cost As the Independent Variable": PM must balance elements differently


1

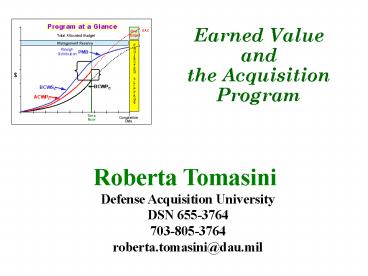

Earned Valueandthe Acquisition Program
Roberta Tomasini Defense Acquisition
University DSN 655-3764 703-805-3764 roberta.tomas
ini_at_dau.mil
2
What is Earned Value Management?
  • Definition
  • EV Concept and Terms
  • EV Policy Update (March 2005)
  • EV in Program Execution (Reporting, Analysis,
    EACs, TCPI)
  • Things to Look At (Analysis Tips)
  • Possible Actions for EVM Reporting Issues
  • Possible Actions for Issues Highlighted by EVM

3
Earned Value Management (EVM) Definition
  • The use of an integrated management system that
    coordinates work scope, schedule, cost goals
    objectively measures progress toward these goals.

4
EARNED VALUE CONCEPT
  • A Management Technique
  • Emphases Disciplined Integration of Technical
    Performance to Associated Cot Schedule
  • Objectively Measures Work Progress
  • States Value of Work Completed in s
  • Provides Objective Cost
    Schedule Metrics
  • Enables Trend Analysis
    CAIV Trades
  • Industry Standard ANSI/EIA-748-2007

DoD Industry embrace EARNED VALUE as a
Risk Management Tool
5
Earned Value Terminology
Acronym
Term
Meaning
BCWS
Budget Cost of Work Scheduled
Plan - Baseline - PMB
BCWP
Budget Cost of Work Performed
Earned Value
ACWP
Actual Cost of Work Performed
Actuals
BAC
Budget At Completion
Planned Cost
EAC
Estimate At Completion
Forecasted Cost
Accomplishment Variance
SV
Schedule Variance
EV vs Actual Cost
CV
Cost Variance
Forecasted Overrun / Underrun
VAC
Variance At Completion
6
The Time-Phased Spend Plan
NEGOTIATED CONTRACT COST Target Cost

BAC
PMB
BCWS
Completion Point
Months
7
Earned Value Management Guidance New Policy
Established in March 2005
Risk Based Decision
Cost Reimbursement Incentive Contracts (EVM on
FFP, LOE TM Contracts Discouraged)
Contract Type
Acquisition Funding
Dollar thresholds are the same for all budget
appropriation categories. Color of money is no
longer an EVM discriminator.
Conformance with ANSI / EIA 748 Formal EVMS
validation not required
Conformance with ANSI / EIA 748 Formal EVMS
validation required
EVM System Requirements
No Mandatory Requirements
Contract Performance Report (DI-MGMT-81466) (5
formats)
Contract Performance Report (DI-MGMT-81466)
(Tailored)
EVM Data Requirements
Integrated Master Schedule (DI-MGMT-81650)
(Tailored)
Integrated Master Schedule (DI-MGMT- 81650)
Contract Value (TY M)
50
0
20
8
EV in Program Execution
  • Data Reporting
  • Data Analysis
  • Variances
  • Performance Indices
  • Trends
  • Estimates at Completion (EACs)
  • To Complete Performance Index (TCPI)

9
Earned ValueWithin the Acquisition Process
GOVERNMENT
PROVIDER
10
Contract/Cost Performance Report (CPR)
  • Format 1 WBS
  • Format 2 Organizational Categories
  • Format 3 Baseline
  • Format 4 Staffing
  • Format 5 Explanations and Problem Analysis
  • NOTE CPR DID, Jul 2005, DI-MGMT-81466A
  • new IPMR DID, 20 Jun 2012, DI-MGMT-81861

11
CPR Format 1 WBS
BCWS
BCWS
BCWP
BCWP
ACWP
ACWP
SV
SV
CV
CV
BAC
EAC
VAC
12
Basic Performance Data Analysis Objectives
  • Determine current status
  • -- Where are we today?
  • Identify trends
  • -- Where are we headed?
  • -- Any cost, schedule surprises ?
  • Forecast the future
  • -- What is the estimated cost at completion?
  • Indicate areas for management action
  • -- What should we do now?

13
Earned Value Metrics
  • Variances
  • Cost and schedule
  • Current month and cumulative
  • Performance indices
  • Cost Performance Index (CPI)
  • Schedule Performance Index (SPI)
  • Percent complete
  • Percent spent
  • To Complete Performance Index (TCPI)

TRENDS
RELATIONSHIPS
14
The Earned Value Current Status Imposed On The
Spend Plan
NEGOTIATED CONTRACT COST

Management Reserve
BCWS
SV
Budget at Completion (BAC)

ACWP
CV
Completion Point
Months
Time Now
15
Cumulative Dollar VarianceCost and Schedule
Trends
in Millions
1.0
0
(1.0)
(2.0)
(3.0)
(4.0)
16
Performance Metrics
  • Cost Variance
  • BCWP - ACWP
  • 10-13 -3M
  • Schedule Variance
  • BCWP - BCWS
  • 10 - 14 -4M
  • Cost Performance Index
  • BCWP/ACWP
  • 10/13 .77
  • Percent Complete
  • BCWP/BAC
  • 10/20 50
  • Percent Spent
  • ACWP/BAC
  • 13/20 65
  • Schedule Performance Index
  • BCWP/BCWS
  • 10/14 .71

Estimate at Completion BAC/CPI
20/.77 26M
17
Gold Card
18
Estimate at Completion(EAC)
EAC Actual Costs accumulated to date
Estimated Cost of the Work Remaining
19
EAC Concept
EAC ACWP Estimate to Complete
Note This EAC assumes that future performance
will be the same as that represented by CPIc.
20
EAC Methods
METHOD FORMULA 1. Cumulative CPI ACWPC
2. Composite ACWPC 3.
3-Month CPI ACWPC 4. Weighted ACWPC
BAC - BCWPC CPIC
BAC - BCWPC CPIC X SPIC
Note c Indicates cumulative data

21
To Complete Performance Index (TCPI)
  • TCPIEAC Work Remaining Budget Required for
    EAC (or cost remaining) BAC-Cumulative
    BCWP EAC- Cumulative ACWP
  • The CPI from today until contract completion
    required to achieve the EAC. Or,
  • The level of efficiency required from today to
    completion to achieve the EAC.
  • Note Compare TCPI EAC to cum CPI for
    believability check

22
Things to Look At (Analysis Tips)
  • Look at CPI in latest CPR - What is CPI cum now?
  • Look at CPI trend - Rate of change? CPI cum drop
    of 1 per month, not green
  • Look at SPI trend Rate of change? Chasing
    schedule?
  • Compare CV and use of Management Reserve MR vs
    Work Remaining?
  • Compare govt EAC to ktr LRE Which is higher?
  • Calculate TCPI for each (govt Most Likely EAC and
    ktr ML LRE)
  • Compare percent complete to percent spent
    greater than 10, not green
  • Look at trend charts for rebaselinings How
    many? When was last one?
  • Look at trend charts relative to /- 10 (OSD)
    and /- 5 (DCMA tripwires)
  • Take govt EAC to price and compare to budget
    (contract total on the R-3)

23
Possible Actions for EVM Reporting Issues
  • PMO discussions with contractor
  • PMO engages DCMA for assistance
  • Discussions with contractor at levels above PM
  • PCO letter
  • Award/Incentive fee impact
  • CPAR input
  • CARs (Correction Action Request)-Levels 1-4
  • DCMA initiated
  • Conduct an IBR
  • Conduct a compliance review
  • Withhold payment up to 5
  • Pull contractors EVM validation

24
Possible Actions for Issues Highlighted by EVM
  • Question What do you do?
  • Answer
  • 1. Find the root cause..talk to the contractor
  • Does it relate to a KPP or KSA?
  • If yes
  • Is there any trade space?
  • Discuss options with the contractor
  • Discuss options with the user
  • If no
  • Discuss options with the contractor
  • Discuss options within Acquisition community
  • 2. Take action to help resolve/mitigate the
    problem

25
  • Any Questions?

26
BACKUP CHARTSfor the Integrated Baseline Review
(IBR)

27
Integrated Baseline Review (IBR) Goal
  • Joint PM mutual understanding of the PMB content
    and the risk

28
IBR PMB Evaluation
  • Assess the following
  • Technical scope of work is captured
  • Work flow and scope ties to contract schedule key
    milestones
  • Resources (budgets, facilities, personnel,
    skills, etc.) are adequate
  • Performance data will reflect project progress
  • Work measurement is objectively planned
  • Assumptions underlying the plan are reasonable
  • SO WHAT DOES THIS MEAN?

29
PMB Budget Allocation Top - Down Version 3
Overrun
30
Developing the PMB
  • 1. Decompose SOW
  • 2. Extend WBS to control account
  • work package

Reports
1. Arrange work packages in order 2. Sequence
over time
1. Budget the work packages 2. Classify the work
and select an EV technique 3. Calculate
cumulative BCWS
31
Control AccountA Key Management Control Point
Work Packages
32
EARNED VALUE TECHNIQUES
METHOD
LENGTH
BCWP CALCULATION
33
BACKUP CHARTS
34
How to Tailor the CPR
  • Can tailor content and/or frequency
  • Format 1 WBS
  • Default WBS level 3
  • Consider Level 4/5 for high risk/dollar areas
  • No more than 2 pages
  • Format 2 Organizational Categories
  • This should be useful for your program
  • Consider aligning to IPTs
  • Format 3 Baseline
  • Format 4 Staffing
  • This will be in the same breakout as Format 2
  • Format 5 Explanations and Problem Analysis
  • Thresholds for variance analysis reporting should
    support management by exception concept
  • Review thresholds periodically
  • NOTE Smaller programs may only need Formats 1
    or 2 and Format 5

35
Primary Trip Wires
  • EVM Center Contractor EVMS confidence rating
  • Corrective Action Requests (CAR Levels 1-4)
  • EVM System maturity levels

36
Secondary Trip Wire Metrics
  • Baseline Execution Index (BEI) IMS
  • Cum index less than .95
  • Schedule Performance Index (SPI) CPR
  • Cum index less than .95
  • Critical Path Length Index (CPLI) IMS
  • Cum index less than .95
  • Cost Performance Index (CPI) CPR
  • Cum index less than .95
  • To Complete Performance Index (TCPI) CPR
  • CPI to TCPI delta of 10
  • Contract Mods ACO, PCO
  • Contract Mods to Original Base value of 10
  • PMB Revisions CPR, CFSR
  • Changes to Monthly Time-Phased PMB value of 5

37
wInsight Current Period
Entries in Black are Input data Entries in Red
are Calculated
38
wInsight Cumulative
39
wInsight At Completion
40
wInsight EAC Forecasts
41
OSD Position on EACs
  • When a contract is more than complete
  • 1. The overrun at completion will be
    than the overrun incurred to date
  • 2. The percent overrun at completion will
    be than percent overrun incurred
    to date
  • Based on OSD database of more than 500 major DOD
    contracts since 1977

20
more
greater
